Short answer

Incremental improvement is often more proportionate when an application still performs useful business work and its problems can be isolated. Replacing a subsystem becomes reasonable when its underlying data model or workflow no longer represents the real requirement. Complete replacement should be considered when the mismatch and risk extend across the wider application.

The sensible first step is usually contained technical discovery. Understand what still works, what is failing, where the business rules live and which systems depend on the application before committing to a rewrite.

Legacy does not automatically mean replace

“Legacy” is often used to describe several different concerns:

  • An application uses an older framework or dependency.
  • It is difficult for a new developer to understand.
  • Changes take too long or regularly cause regressions.
  • Particular screens are slow or unreliable.
  • The data model no longer represents the real business process.
  • The application depends on infrastructure or integrations that are becoming difficult to support.

These are not interchangeable problems, and they do not all have the same solution.

A slow screen may need a better query. An unsupported dependency may need an upgrade. A workflow that has outgrown its original data model may need a substantial redesign. An application that no longer provides enough business value may be better retired or replaced by an existing product.

Microsoft’s application-modernisation guidance similarly treats modernisation as a range of options, including retiring, replacing, rehosting, refactoring, rearchitecting and rebuilding an application. It does not define modernisation as a complete rewrite by default.

The useful question is therefore not, “Is this application old?” It is, “What problem does the business need to solve, and how much of the existing system prevents that?”

Three realistic levels of change

Most decisions fit into one of three broad levels.

Level What it means When it may fit
Contained improvement Correct or modernise a defined part of the existing application. The application remains useful and the problem can be isolated.
Subsystem replacement Redesign and replace one substantial feature, workflow or module while retaining the wider platform. One area is built around unsuitable assumptions, but unrelated areas still work.
Complete replacement Replace the application as a whole, either with a new custom system or an appropriate existing product. Foundational problems affect the wider application and contained change cannot meet the required outcome safely or economically.

This distinction matters because “improve the current system” and “rewrite everything” are not the only choices. A subsystem can sometimes be replaced cleanly without discarding the rest of the platform.

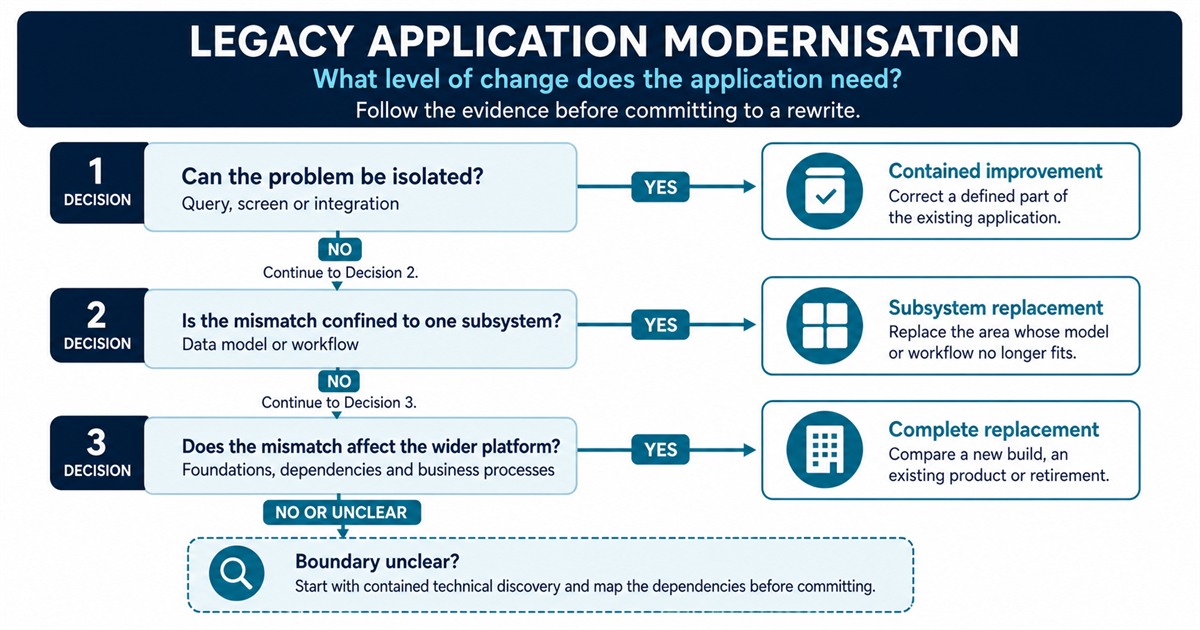

Decision flow for choosing between contained improvement, subsystem replacement and complete replacement
Use contained improvement when a problem can be isolated, consider subsystem replacement when one area no longer fits, and compare complete replacement options when the mismatch affects the wider platform. If the boundary remains unclear, begin with contained technical discovery.

When contained improvement is appropriate

Incremental improvement deserves serious consideration when:

  • The application still supports the real business workflow.
  • Users rely on business rules or features that remain valuable.
  • The main problems can be traced to identifiable screens, queries, integrations or processes.
  • The existing data model can represent the current requirement.
  • A contained change can be tested and deployed without destabilising unrelated areas.
  • The business needs a proportionate improvement rather than a long replacement programme.

Effective contained improvement begins with diagnosis, has explicit boundaries and includes suitable testing. Repeated patches applied without understanding the cause are unlikely to provide that.

Example: slow data-table screens

In one existing business application, some data-table screens retrieved the complete dataset and then performed filtering, sorting or paging in application code. A user might see only 20 records, while the application retrieved thousands.

As the amount of data grew, users experienced very slow loading screens and request timeouts. The wider application was still performing its business function correctly; the problem was concentrated around how these screens retrieved data.

The querying, filtering and paging were moved server-side. SQL Server stored procedures returned only the data required for the current view instead of sending the full dataset to the application. The screens became significantly faster and related support complaints reduced.

The improvement came from correcting the retrieval pattern: the application stopped requesting and processing large amounts of data that the user was never going to see. Stored procedures were the delivery mechanism in this case, not a universal answer for every query.

Replacing the application would not have addressed this problem more intelligently. It would have introduced wider delivery and migration risk to solve a bottleneck that could be isolated and corrected.

When replacing a subsystem is appropriate

A subsystem replacement becomes more reasonable when a substantial part of the application is based on an assumption that is no longer true.

Typical signs include:

  • The underlying data model cannot represent the required level of detail cleanly.
  • New requirements repeatedly need exceptions or compensating calculations.
  • The same limitation affects data entry, validation, calculations, reporting and integrations.
  • Correcting the problem means changing most of the subsystem rather than one contained path.
  • The subsystem has a clear enough boundary that the surrounding platform can remain in place.

Together, those signs can indicate that one part of the application has reached the limit of its original design. The wider platform should be assessed separately rather than included in the replacement by assumption.

Example: a time-based entitlement subsystem

A substantial time-based entitlement subsystem within a larger business platform had originally stored values as decimal hours. That worked for the simpler requirement around which it had been designed.

Real usage later required precise sub-hour values. Some minute values do not convert cleanly into a finite decimal fraction of an hour, which introduced recurring representations, rounding behaviour and increasingly complicated calculations. The problem was not confined to one screen: the stored value was used by balances, calculations, reports and user workflows.

The subsystem was redesigned to store whole minutes internally. A value of 1.5 hours, for example, became 90 minutes. Users did not have to think in total minutes; the interface accepted natural hour and minute values and normalised them for storage.

Existing values were converted to the nearest minute and written to a new field. The original hour-based values were retained rather than overwritten, providing a source for reconciliation if a converted record was questioned. Affected organisations were told about the change and could review or correct their records.

The change also reached well beyond the new field. Reports, calculations and screens had to convert the internal minute value into a human-readable duration. An internal value of 90 minutes, for example, needed to appear as one hour and 30 minutes.

Testing effort was comparable to development effort. The developer tested the changes before they went through extensive testing by a separate team. Edge cases and missed dependencies emerged, were corrected and were tested again. A recurring defect was an overlooked area continuing to read or interpret the original hour-based value.

Replacing this subsystem was justified because its central representation no longer fitted the real requirement. Replacing the surrounding platform was not justified because unrelated areas remained useful.

When complete replacement may be justified

Complete replacement deserves investigation when the foundational mismatch is not confined to one subsystem.

Possible signals include:

  • The application’s central data model no longer represents how the organisation operates.
  • Required changes cut across nearly every workflow, screen and integration.
  • Critical dependencies cannot meet the organisation’s support, security or operational requirements.
  • The application cannot be changed or deployed with an acceptable level of confidence.
  • Essential business rules are spread throughout the system and cannot be separated into safer increments.
  • A suitable established product can meet the requirement with less custom development and operational risk.
  • The cost and disruption of retaining the application are supported by evidence, not simply a preference for newer technology.

Use these signals as prompts for investigation rather than an automatic scoring system. Poor test coverage, for example, makes incremental change harder, but it also makes a rewrite risky because the existing application may be the only complete record of its business behaviour.

Likewise, moving from .NET Framework to modern .NET is a technical upgrade path, not necessarily an application replacement. Microsoft recommends assessing the application, its configuration and dependencies, choosing an appropriate upgrade path and validating the result.

A runtime upgrade, architecture change and business-process replacement may be related, but they are separate decisions and should not be bundled together without a clear reason.

Risks that are commonly underestimated

Hidden business rules

Older applications often contain behaviour that is no longer documented elsewhere. A field validation, report calculation or unusual exception may exist because of a real operational requirement. Recreating only the visible screens can omit those rules.

People who use the application day to day should be involved in discovery and testing. Their knowledge may be as important as the source code.

Data migration

Changing a data model requires more than copying values into a new table or column. The work may need:

  • Explicit conversion and rounding rules.
  • Treatment of invalid, incomplete or contradictory records.
  • Reconciliation between source and converted values.
  • A decision about whether historical records should retain their original interpretation.
  • A correction route for users or administrators.
  • A rollback or recovery plan if the conversion is wrong.

Where practical, retaining the original value during transition provides useful evidence. It should not be discarded merely because the replacement representation appears to work.

Reports and integrations

Data is rarely consumed only by the screen where it is entered. Reports, exports, scheduled jobs, APIs and connected systems may all depend on its meaning.

A schema search is useful, but it is not always sufficient. Dynamic SQL, copied calculations, external reporting tools or manual operational processes may not be obvious from one code repository.

Testing and correction

Foundational changes need representative data and realistic workflows. Testing should cover boundaries, conversions, reports, existing records and the transition between old and new behaviour.

Testing is doing useful work when it exposes problems before release. Estimates should allow time for defects to be corrected and retested rather than treating the first implementation as the finished result.

Communication and user correction

If a migration converts or rounds user-owned data, the affected people need to understand what changed. Where appropriate, they should be able to review and correct the result.

A technically consistent migration can still damage trust if users discover unexplained changes after release.

A practical decision framework

1. What is the actual business problem?

Describe the user impact, operational cost or delivery constraint. “The application is old” is not specific enough.

2. What still works and remains valuable?

Identify the workflows, business rules, data and integrations that should be preserved. Replacement has a cost when it recreates working behaviour as well as when it corrects poor behaviour.

3. Can the problem be isolated?

Trace whether the issue belongs to a particular query, screen, integration or subsystem. If it has a clear boundary, contained improvement or subsystem replacement may be possible.

4. Does the current data model represent the real requirement?

If the model can express the required workflow cleanly, improvement may be enough. If the model forces repeated exceptions throughout the system, a deeper redesign deserves investigation.

5. Who and what depends on the affected behaviour?

Map users, reports, scheduled jobs, exports, APIs and external systems. A small-looking database change can have a large dependency surface.

6. How will data be converted and checked?

Define conversion, rounding, reconciliation, correction and rollback before implementation begins.

7. How will the old and new behaviour be tested?

Use representative records and real workflows. Include the people who understand the business process as well as those implementing the change.

8. Is custom development still the right answer?

If a suitable product already meets the requirement, replacing the application with that product may be more sensible than either rewriting or extending custom software.

Start with contained technical discovery

When the answer is not obvious, a useful first engagement is a contained technical discovery rather than a commitment to rewrite.

Its output should be practical:

  • A map of the relevant application areas and dependencies.
  • Evidence of the current problem and its user impact.
  • The business rules and data that must be preserved.
  • The principal migration, integration and deployment risks.
  • A comparison of contained improvement, subsystem replacement and complete replacement.
  • A recommended first piece of work with an explicit boundary.

Discovery should reduce uncertainty enough to make the next decision while remaining a contained exercise, rather than expanding into documentation work that delays every improvement.

Where IncaStack fits

IncaStack is suited to contained technical discovery, correcting identifiable problems in an existing .NET application, and replacing a well-defined subsystem where the surrounding platform remains useful. You can read more about support and development for existing .NET applications.

A complete organisation-wide transformation requiring several parallel development teams, extensive programme management or continuous operational coverage would normally need a larger delivery team. IncaStack may still be able to define the problem or deliver a contained part, but should not present itself as the sole supplier for work beyond its practical delivery capacity.
